HET Beginning-Trimester Report
  Second Period of 2023
April 1 - July 31

This report is primarily to give updates to PIs on recent changes/improvements and to summarize the determination of time allocations for the 23-2 trimester.



Updates on recent changes/improvements:


Collecting Efficiency

    We continue to work towards implementing a significant improvement to the Phase II Target Submission Language parameterization of sky transparency. Instead of requesting N/S/P conditions (0%/50%/90% transparency), users will soon request a minimum value of Collecting Efficiency (CE) for their observation, where:

    Collecting Efficiency  =  Sky Transparency * Primary Mirror Pupil Illumination

This will give users more detailed information and control over their data quality. There is documentation available to describe how to estimate CE for your targets and what types of values are reasonable to request: https://hydra.as.utexas.edu/?a=help&h=140
    Sky Transparency varies between 0.0 (fully cloudy) and 1.0 (fully clear) and Pupil Illumination varies between 0.5 (tracker at extreme edge) and 1.0 (tracker centered over the mirror), so CE varies from 0.0 to 1.0. Note that we also provide an online Filling Factor Calculator to determine the maximum pupil illumination available for a given declination and exposure time. Experienced users will be aware that longer exposures experience worse pupil illumination: at Dec=+45deg, a 10min exposure has an average pupil of 97% but a 30min exposure has only 91% pupil illumination. This impact should be considered carefully when requesting CE in the future!
    Beginning in 23-1, all observations reported on the "Objects Observed" tab on Hydra include the CE for each exposure. Users are strongly encouraged to use this opportunity to become familiar with the typical values of CE during regular observations:

Remember that "Sky conditions" (green arrows above) include the average sky surface brightness (in the listed SDSS filter) during your exposure, and the average transparency in parentheses. The new column for C.E. appears under the orange arrow in the screenshot above.
    Starting in 23-3 we hope to transition to CE and discontinue the use of SKYTRANS. Additional information will be forthcoming about this important transition.


MOONDOWN TSL keyword

    Starting in the 23-2 trimester (1-April 2023) we are using the new TSL keyword "MOONDOWN" which can be used to request that the moon be below the horizon during the entire visit (and that the visit be completed within the dark portion of the night between 18-deg twilights). In the past, SKYBRIGHT_X (where X = g, r, or i) of exactly 21.0 was an indication that the moon should be below the horizon. Starting in 23-2 we are treating the sky surface brightness keywords literally.











Commissioning, Engineering, and Guaranteed Time allocations

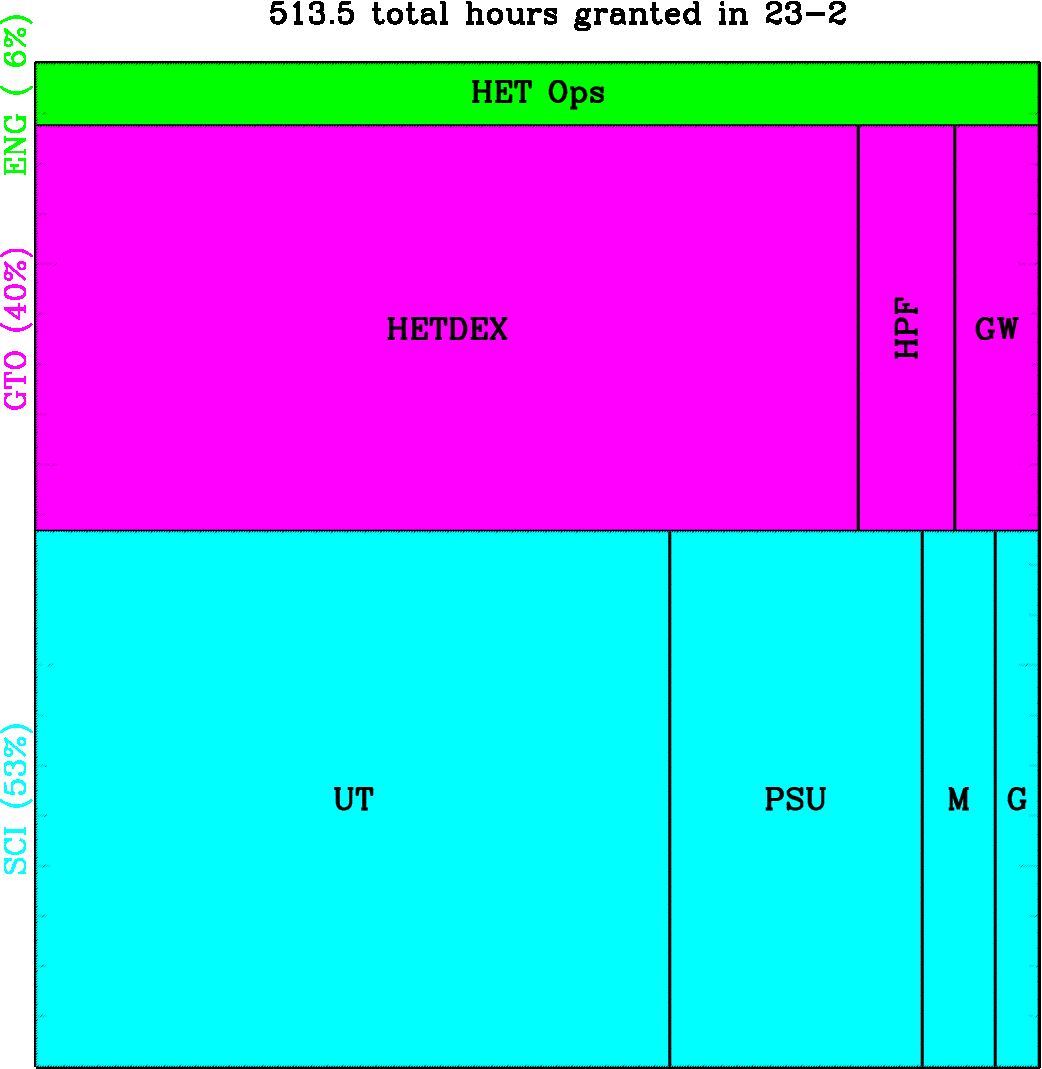

The HET Board granted the following allocations for the 23-2 period:


In total the Board granted 239.5 hours of Comm/Eng/GTO time in 23-2, which is the lowest of the past few years' second trimesters.






Breakdown of how science hours for TACs at each partner were determined:



quantity
Apr
(hrs)
May
(hrs)
Jun
(hrs)
Jul
(hrs)
Total
(hrs)
18deg-18deg times
248.20
224.58
199.88
215.15
887.82
Weather loss frac. 0.39
0.38
0.44
0.49

Efficiency loss frac.
(align+PRs)
0.06
0.06
0.06
0.06

"Clear science" time
142.32
130.89
105.22
103.14
481.57
Com/Eng/GTO time
 *calculated based on
  statistical averages of
  time actually used in
  previous ~3 years




188.00


"Allowed" hours
given to TACs
for science




293.57






Hours allowed for each TAC as determined Feb 16, 2023:


Partner
Share
Time deficit
correction
Total hours
allowed
Allocated
as of Apr 2
(excl. Pr4)
Goettingen
0.03860
+0.76
12.09
12.10
Munich
0.05724
+2.70
19.50
19.50
PSU
0.24897
-3.80
69.29
67.80
UT
0.65518
+0.34
172.68*
173.08
*20h of TESLA time were moved from UT to the HETDEX program

Corrections were applied using 20% of the cumulative deficits in time balance between the partners. As of August 1st 2022, those time deficits were:
  UT:   1.7h deficit
  PSU: 19.0h surplus
  M:    13.5h deficit
  G:     3.8h deficit
Actual time usage is carefully monitored to ensure equitable balance between the partners; these corrected allocations should help improve this balance over the long-term.

Note that effective 1-Dec 2022, TACs may allocate up to 13.3% at P0*, 20% at P1*, 33.3% at P2 and 33.3% at P3; P4 allocations are not restricted. Priorities of Com/Eng/GTO time are assigned by the HET Board.

*In September 2022 the HET Board approved a proposal (available here) from the Users Committee to temporarily change the fractional time allocations at each priority. After the HETDEX guaranteed time observations are completed, the priority breakdowns will return to the previously adopted fractions.


Pr 0
Pr 1
Pr 2
Pr 3
Pr 4
previously,
through 22-3
1/12th
(8.3%)
3/12th
(25%)
1/3rd
(33.3%)
1/3rd
(33.3%)
n/a
starting 23-1 (changes
     to Pr0 and Pr1 only)
2/15th
(13.3%)
3/15th
(20%)
1/3rd
(33.3%)
1/3rd
(33.3%)
n/a
after the completion of
Guaranteed Time for
HETDEX observations
1/12th
(8.3%)
3/12th
(25%)
1/3rd
(33.3%)
1/3rd
(33.3%)
n/a












SJ, 2 Apr 2023
